Custom cabinetry is difficult and expensive to correct after it reaches the jobsite. A pre-shipment inspection is therefore not a beauty check at the end of production; it is a structured verification that the cabinets being packed match the approved drawings, dimensions, finishes, hardware and functional requirements.
· Published
For kitchens, wardrobes, vanities and whole-home built-ins, we recommend checking the project in layers: first the specification, then the cabinet boxes and machining, then trial assembly and moving parts, and finally the finished surfaces and export packing. This sequence makes defects easier to trace and correct before the shipment leaves the factory.
1. Why pre-shipment inspection matters for custom cabinets
Cabinetry is a system of panels, doors, drawers, hinges, slides, lighting, fillers and site interfaces. A small error in drilling or panel size can affect several downstream parts. Pre-shipment QC reduces the risk of discovering those errors only after international delivery.

2. Start with drawings, finish samples and the order specification

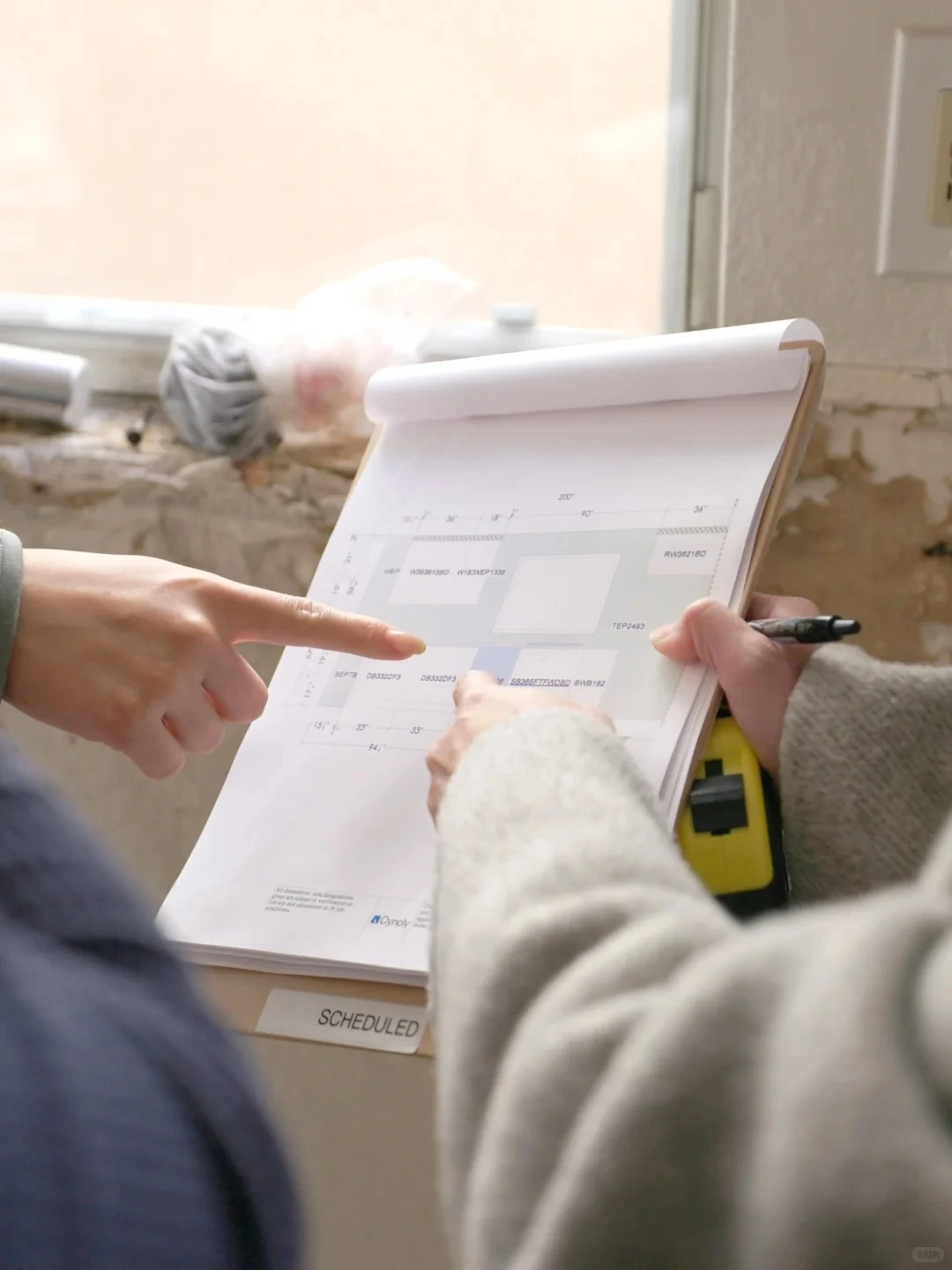

Inspection should begin with the approved production drawings and finish schedule. The inspector verifies cabinet IDs, quantity, door style, finish code, internal configuration, appliance openings and special accessories. If the reference documents are wrong or outdated, a precise measurement can still approve the wrong product.
What should be matched against the drawing?
Overall width, height and depth; toe-kick and filler dimensions; shelf positions; drawer count; hinge side; appliance openings; handle or pull locations; internal accessories; visible end panels; and any lighting channels should all trace back to an approved document.

3. Verify dimensions, panel thickness and machining

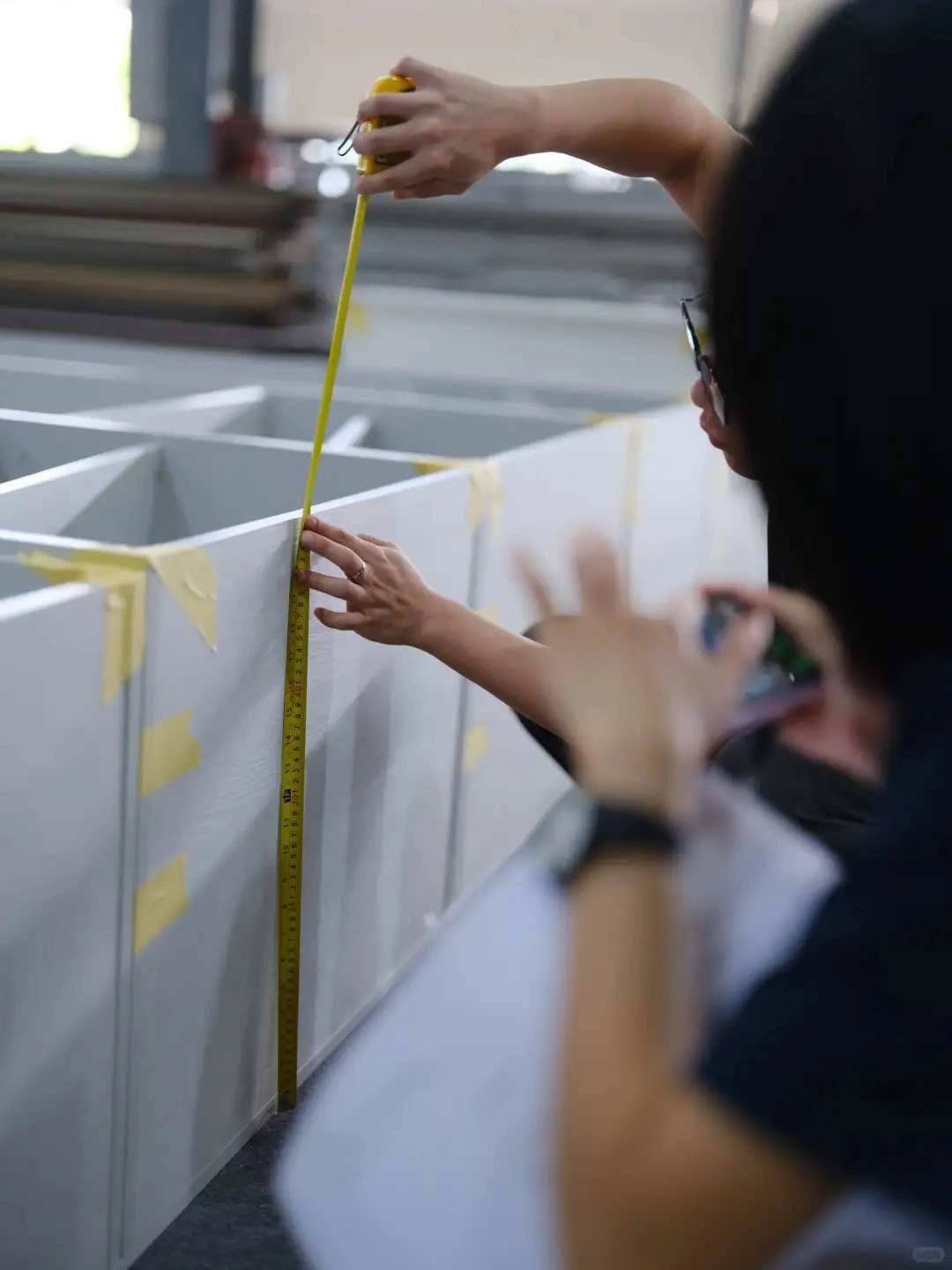

Next, check the physical cabinet against the drawings. Critical dimensions deserve direct measurement rather than visual judgment. Hole locations, shelf-pin rows and panel thicknesses should be consistent enough that installation and replacement parts remain predictable.

4. Trial-assemble cabinets before packing

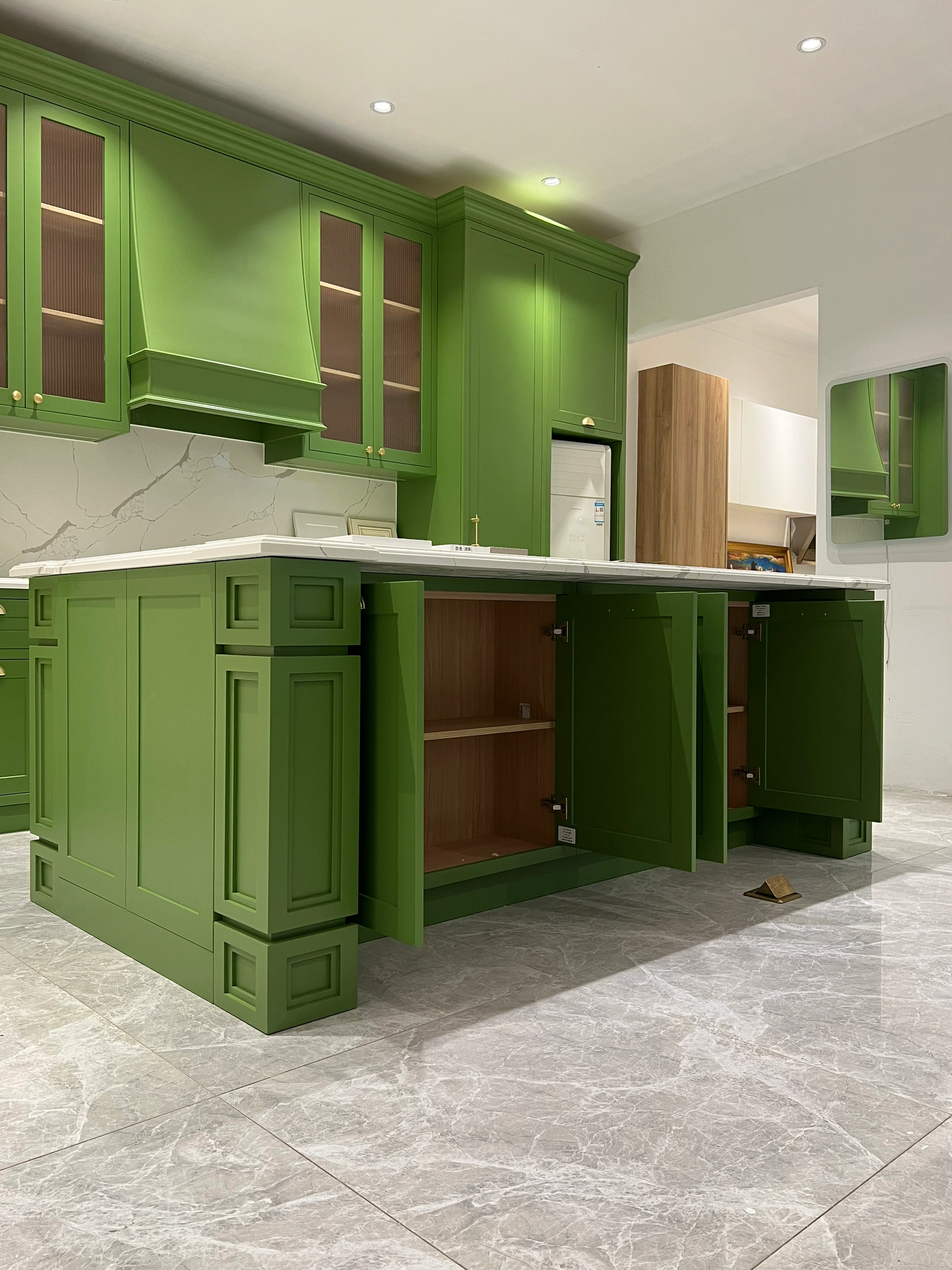

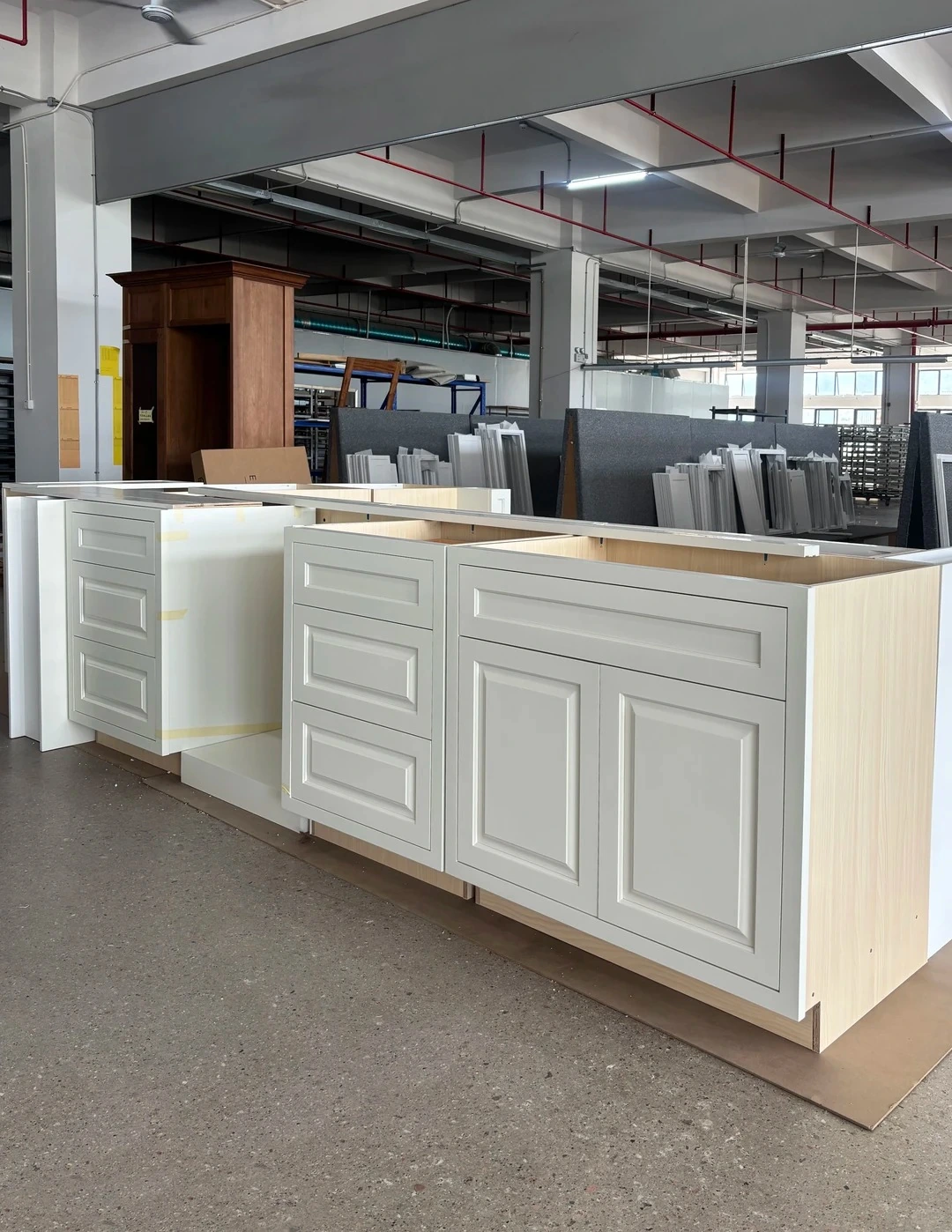

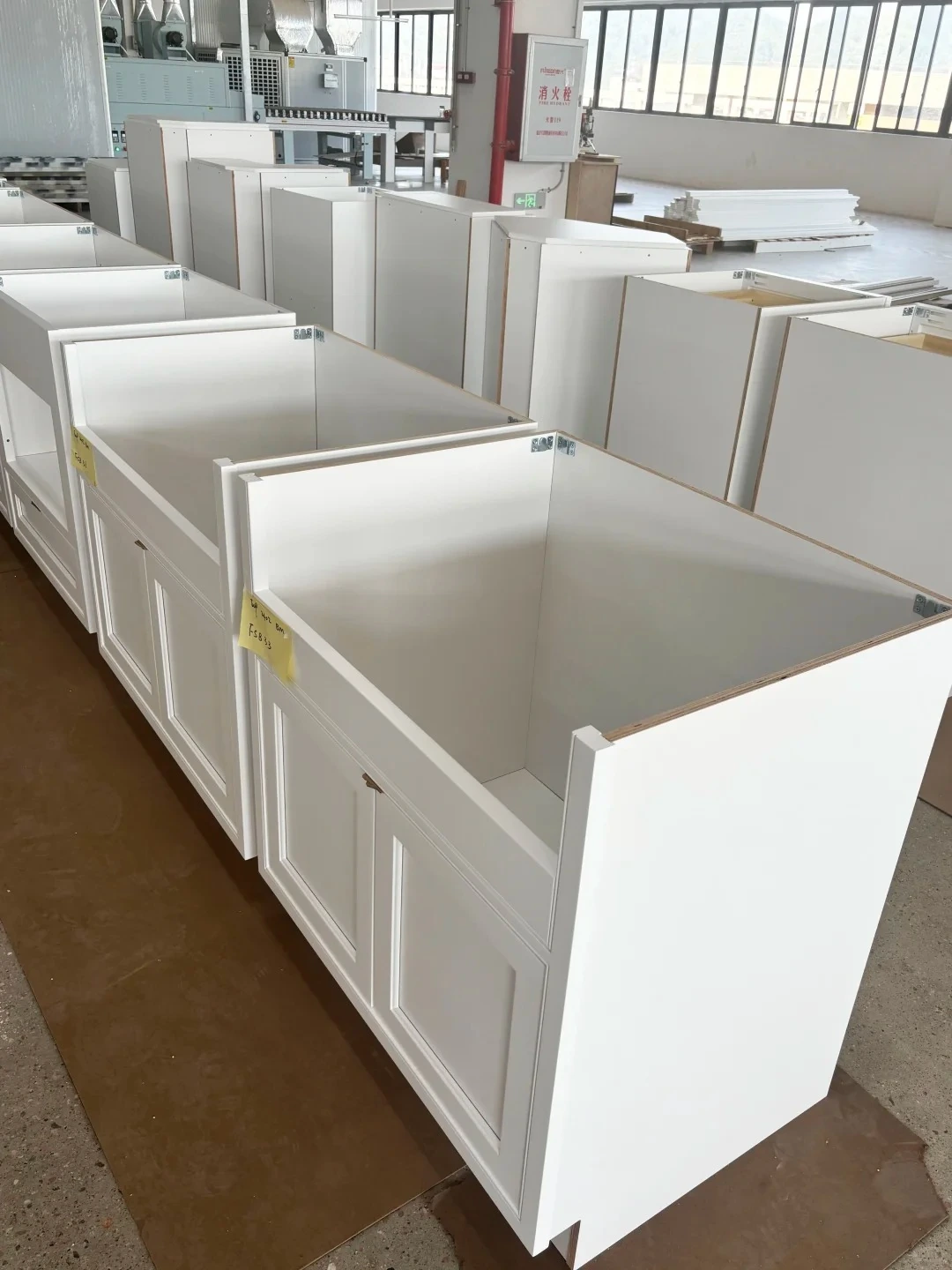

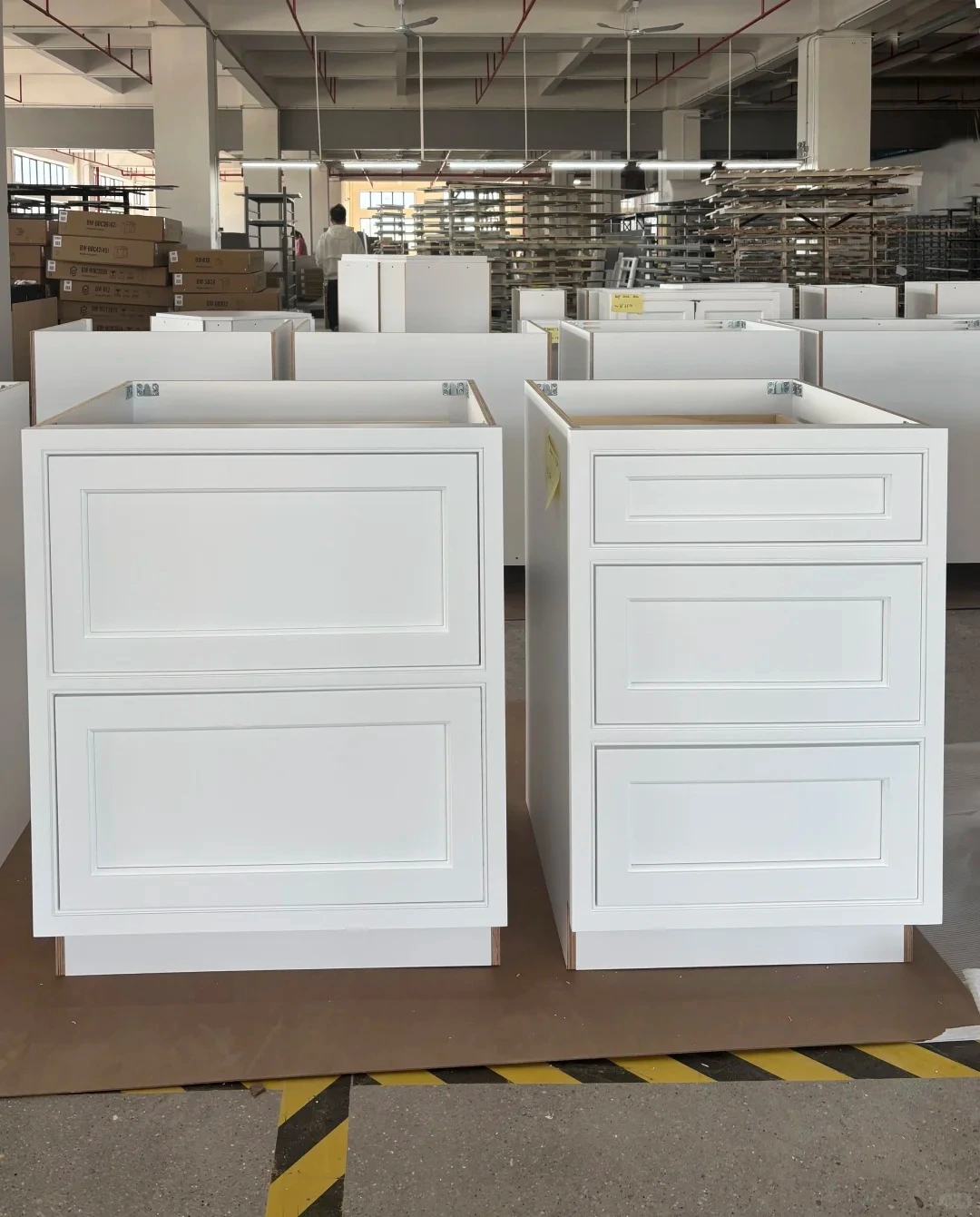

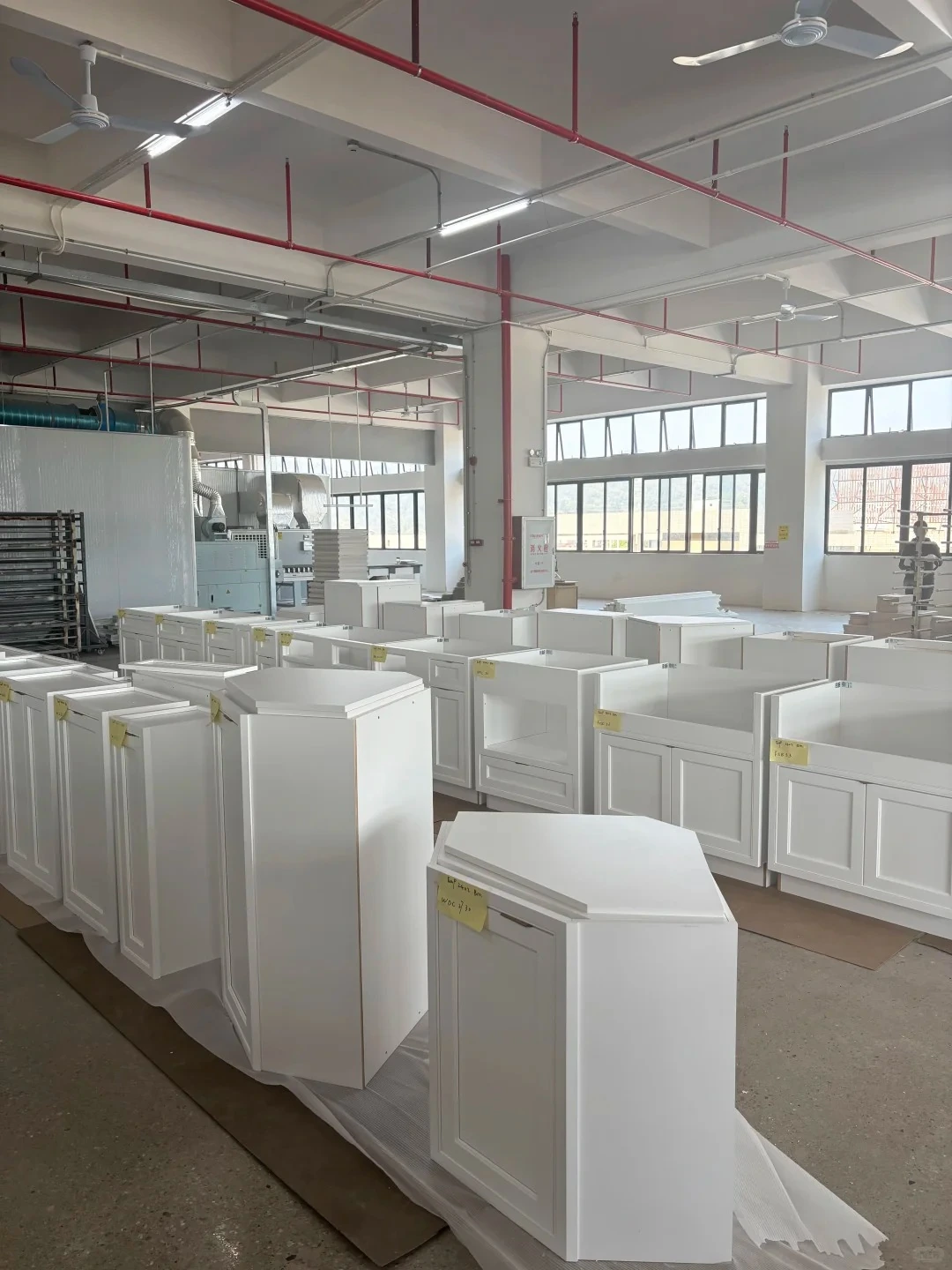

Trial assembly is one of the most useful QC steps for custom cabinetry. It reveals issues that are difficult to see when parts are inspected separately: uneven reveals, incorrect fillers, door interference, drawer conflicts, misaligned panels and inconsistent module heights.
For large projects, photograph cabinet IDs during trial assembly so the inspection evidence can later be matched to the packing list and installation drawings.

5. Inspect hinges, slides, drawers and internal hardware

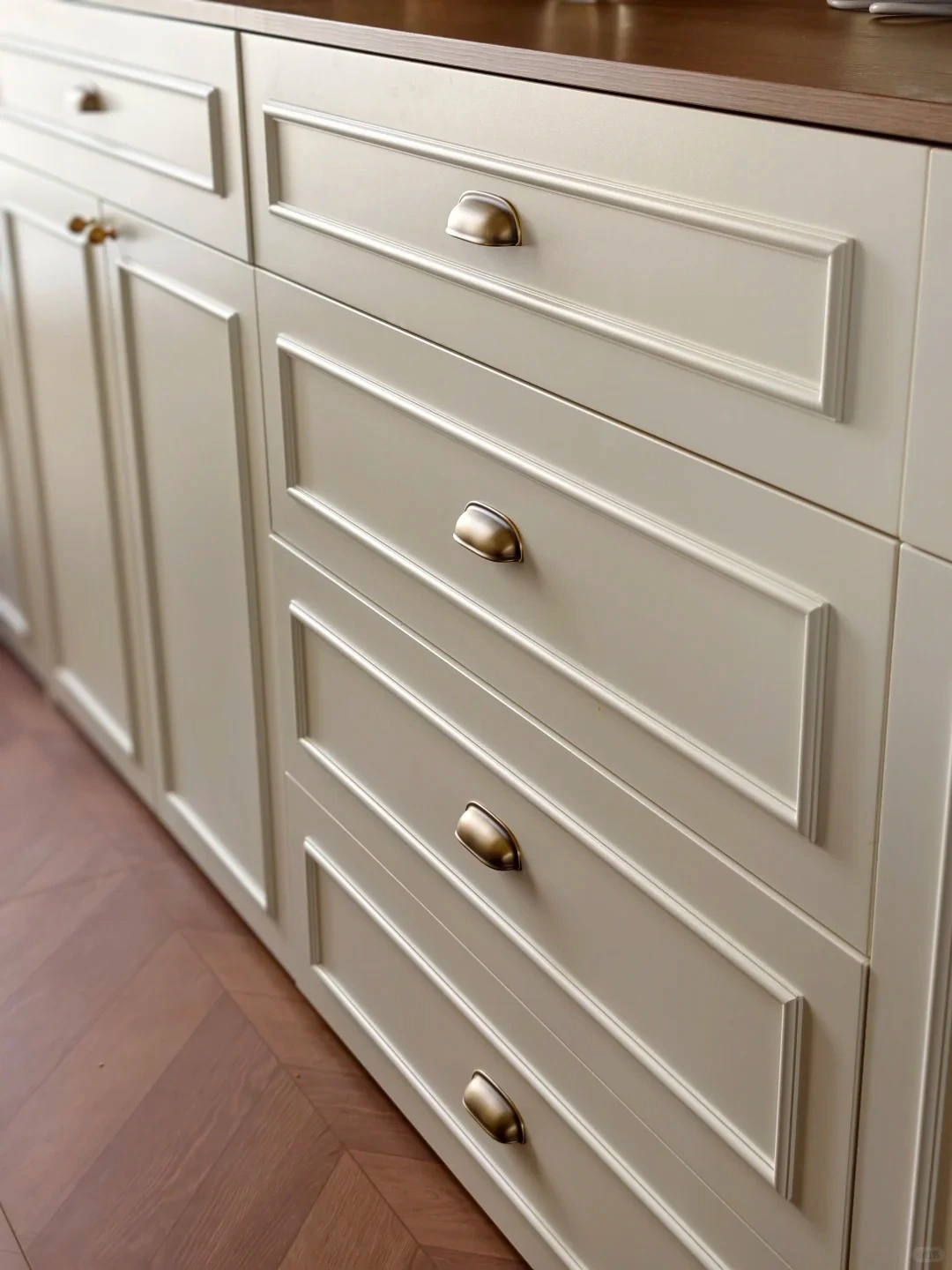

Hardware is not complete simply because it is present. Doors should open without rubbing, hinges should sit firmly and consistently, drawers should travel smoothly, and internal accessories should operate through their full range. Soft-close mechanisms should engage predictably rather than only on selected units.

6. Check edge banding, joints, surfaces and finish consistency

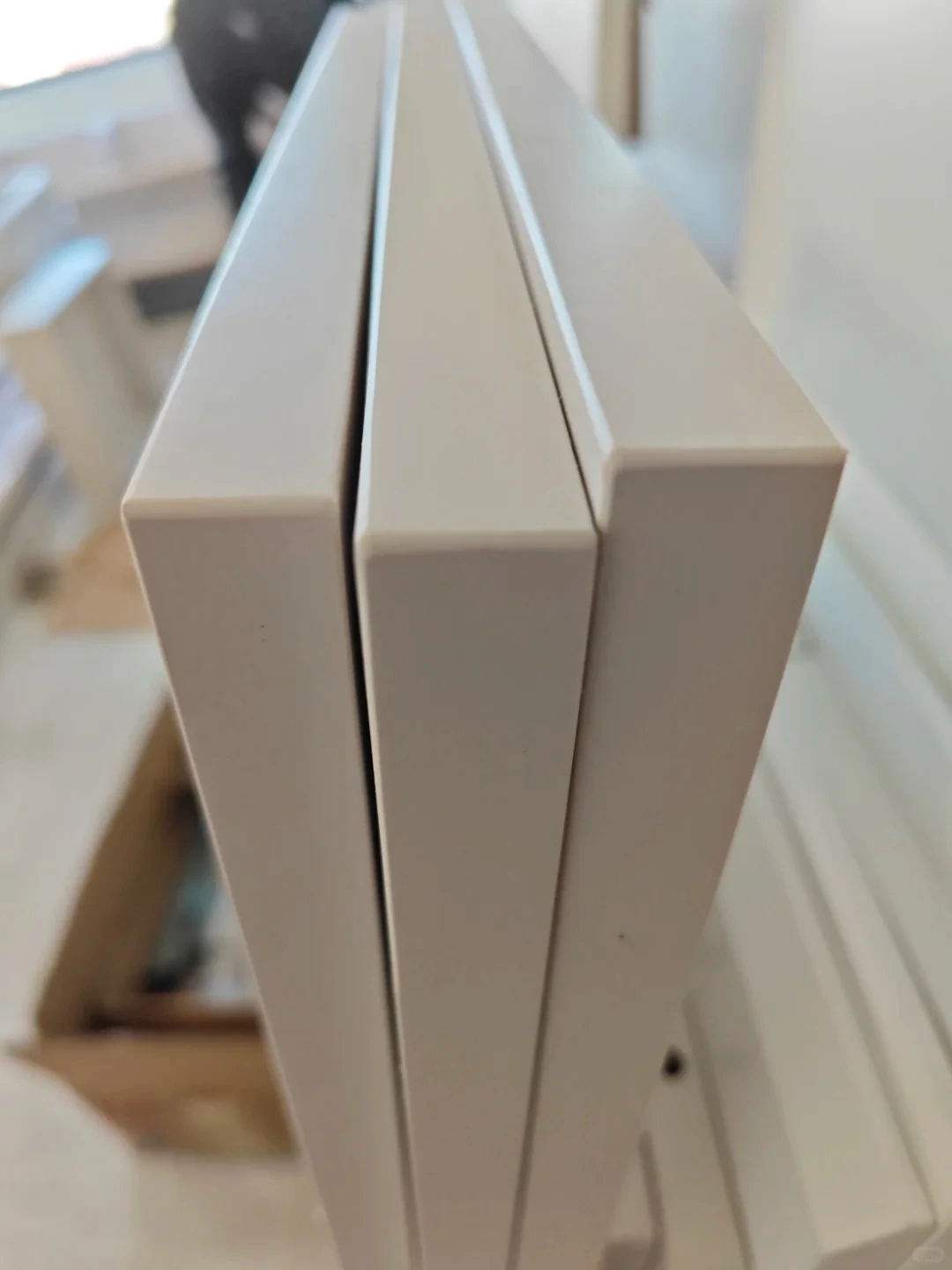

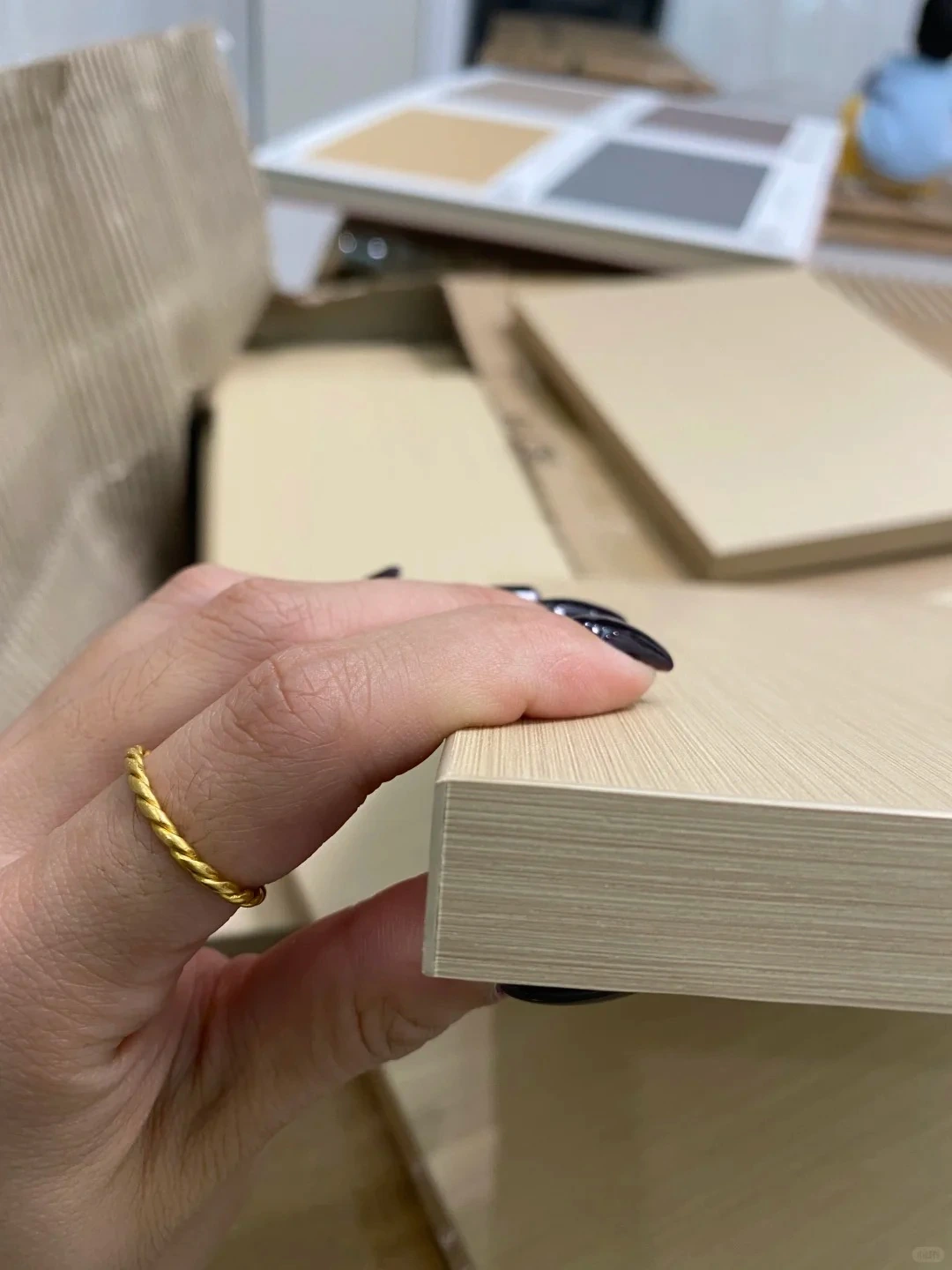

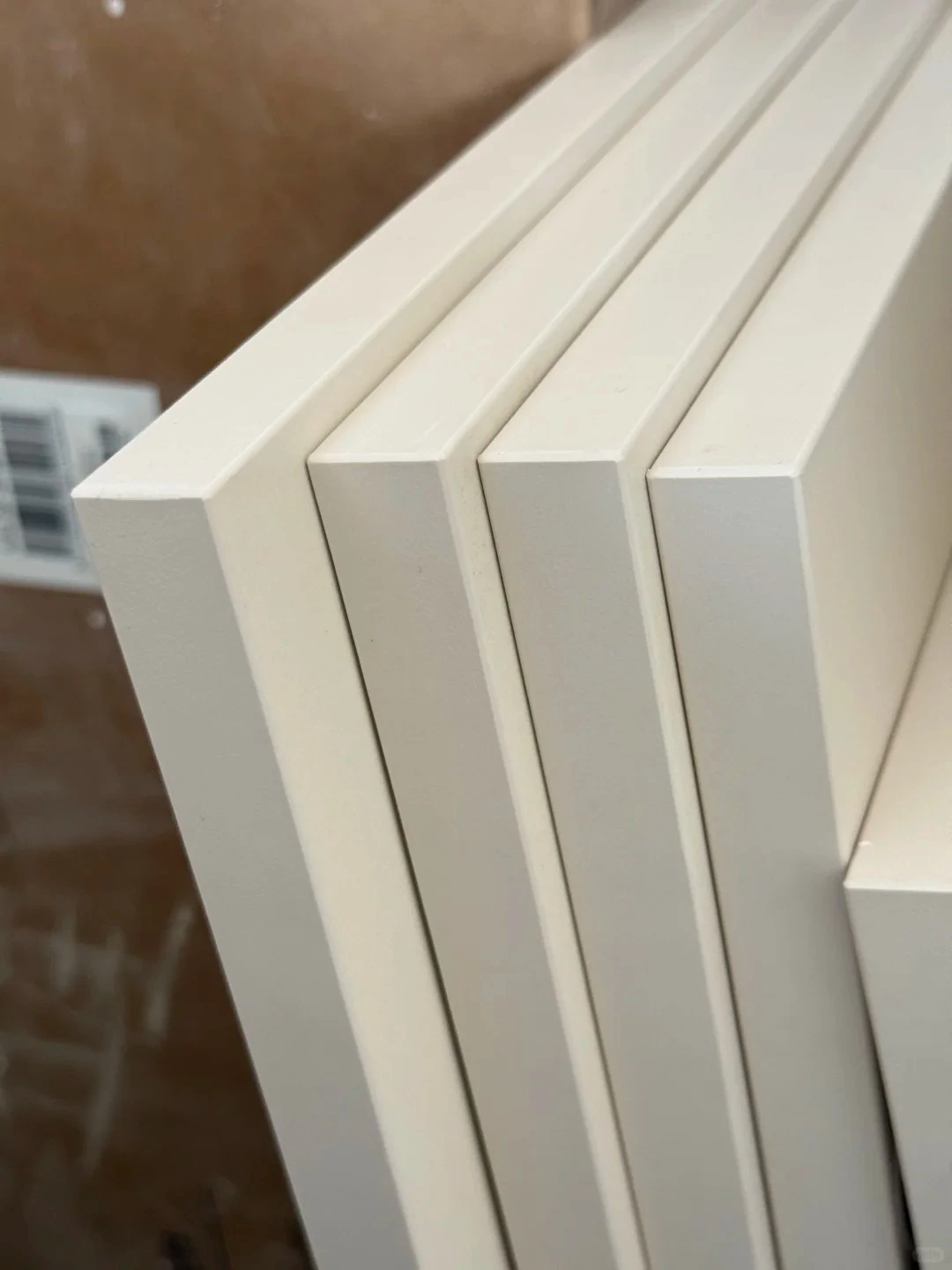

Edges are high-risk areas because they are handled during assembly and are exposed to moisture and impact in daily use. Inspect for lifting, gaps, chipped corners, excess adhesive, inconsistent edge thickness and visible color mismatch. Finished fronts should also be checked under consistent lighting for scratches, dents, pinholes, color variation and uneven sheen.

7. Test lighting and integrated accessories

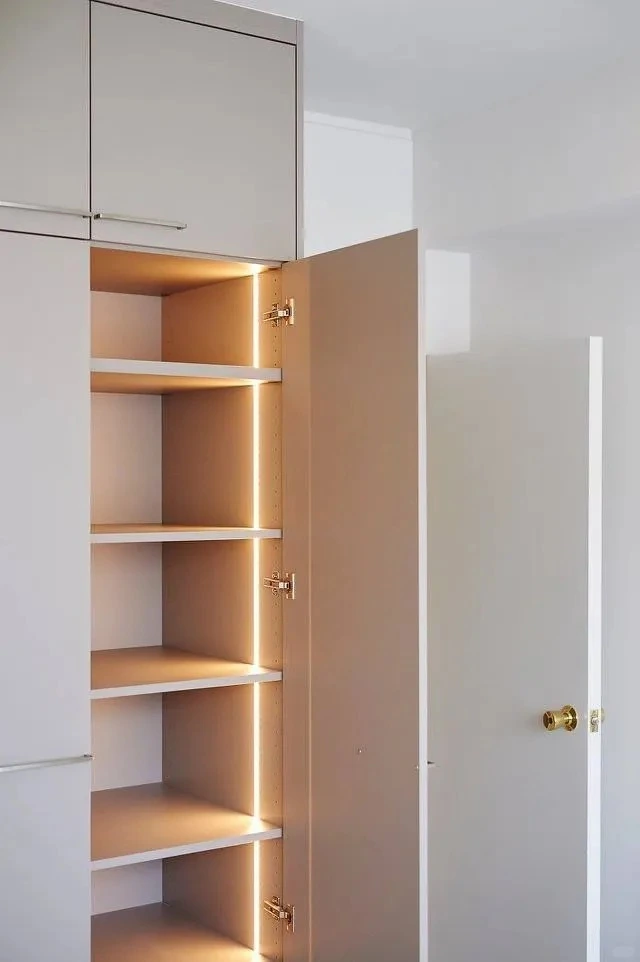

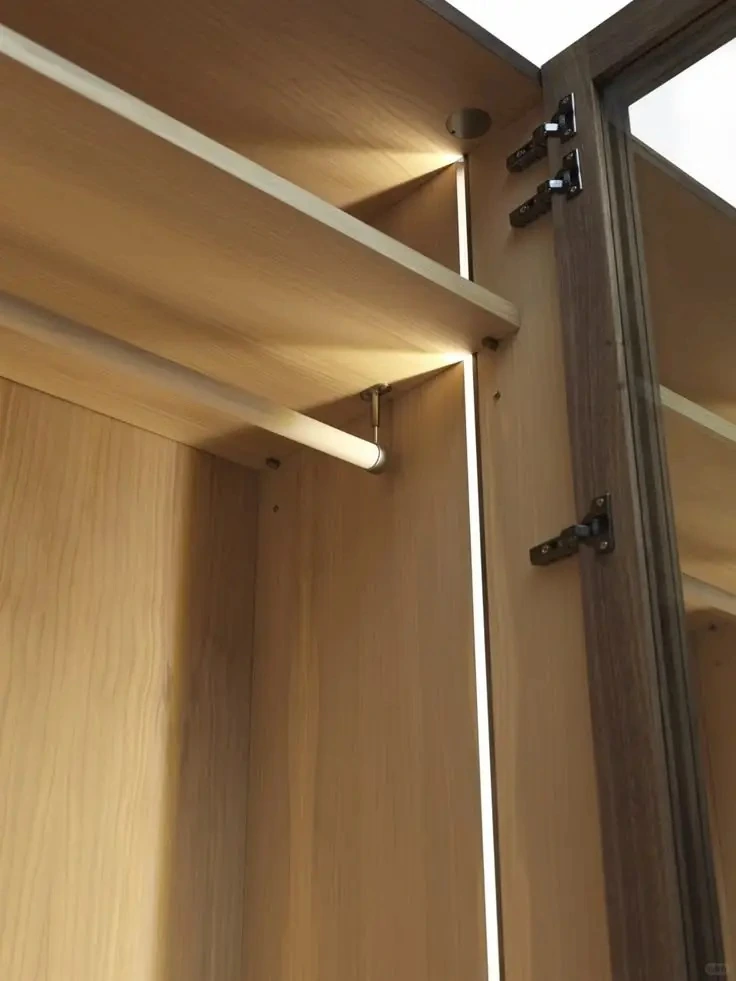

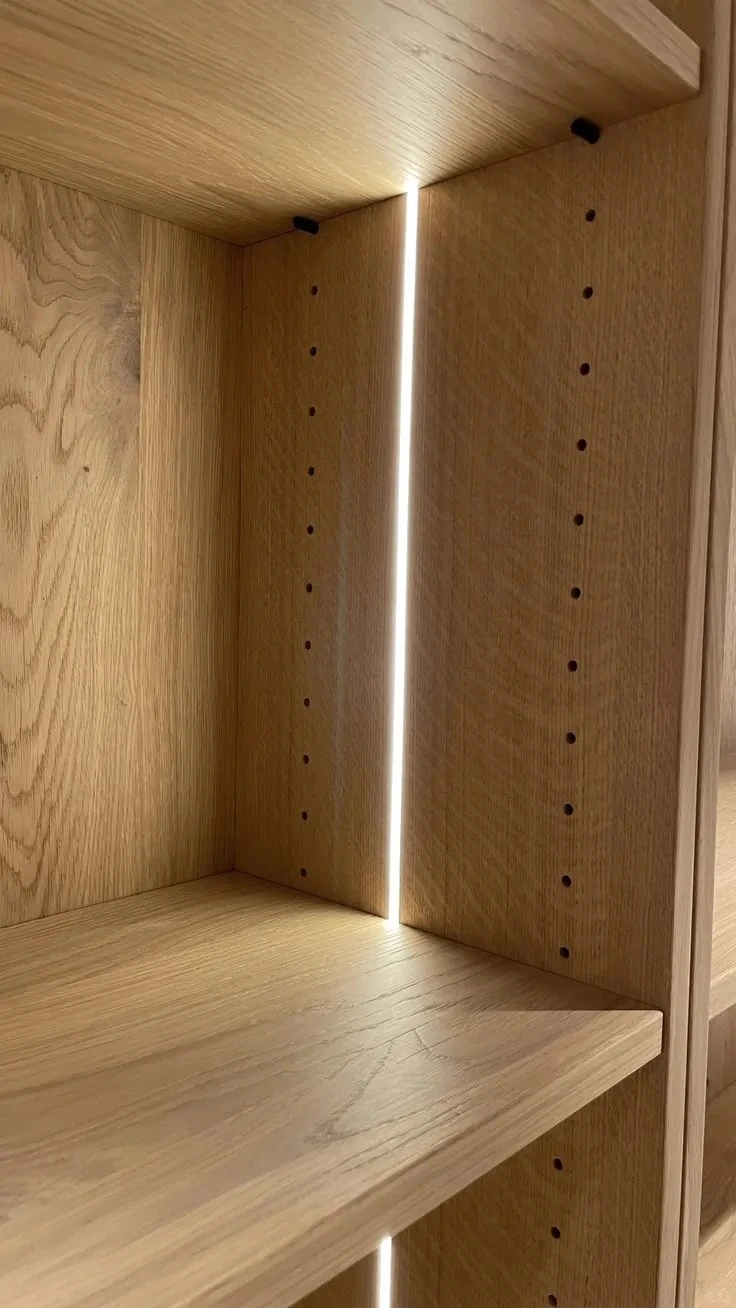

If cabinetry includes LED strips, sensors or integrated power accessories, test them before packing. Confirm that the channel, diffuser and wiring route match the approved design, and that doors or shelves do not interfere with the lighting system.

8. Review the complete cabinet as the client will see it
After structural and functional checks, step back and evaluate the visible result. Look at door and drawer reveals, grain or color continuity, handle alignment, symmetry, filler relationships and the overall composition. This is where individual tolerances become a finished visual system.

9. Inspect export packing before the container is closed

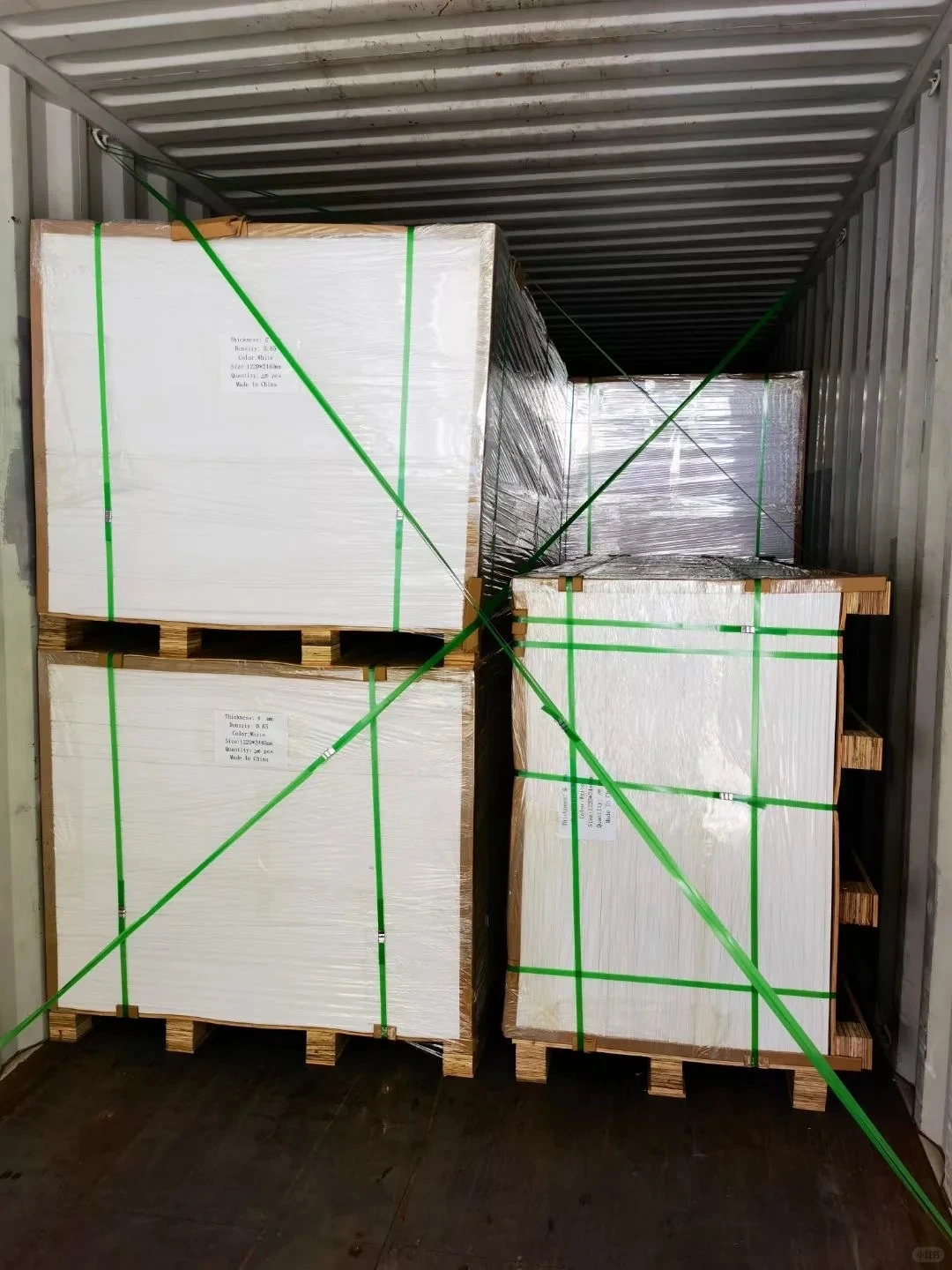

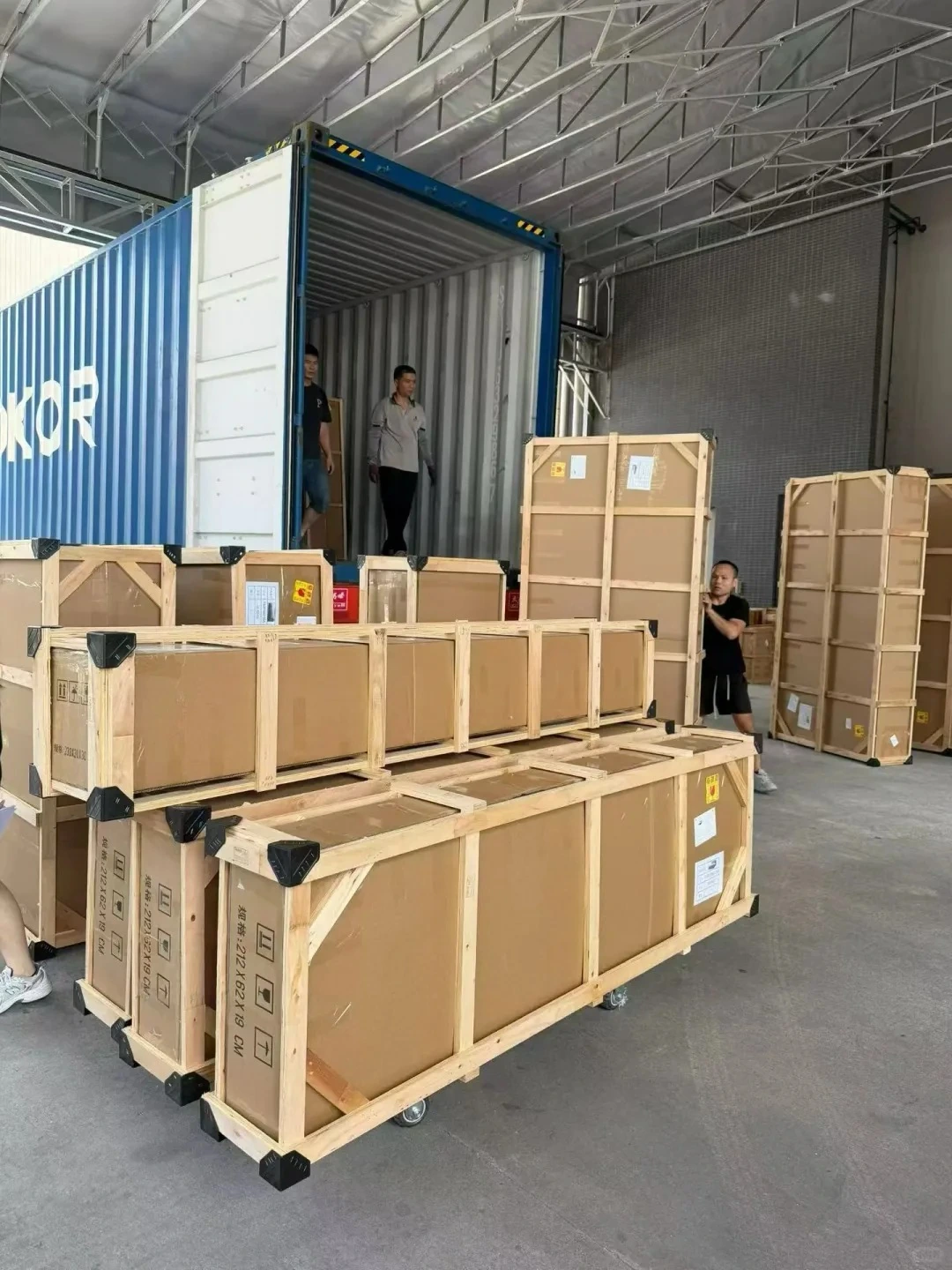

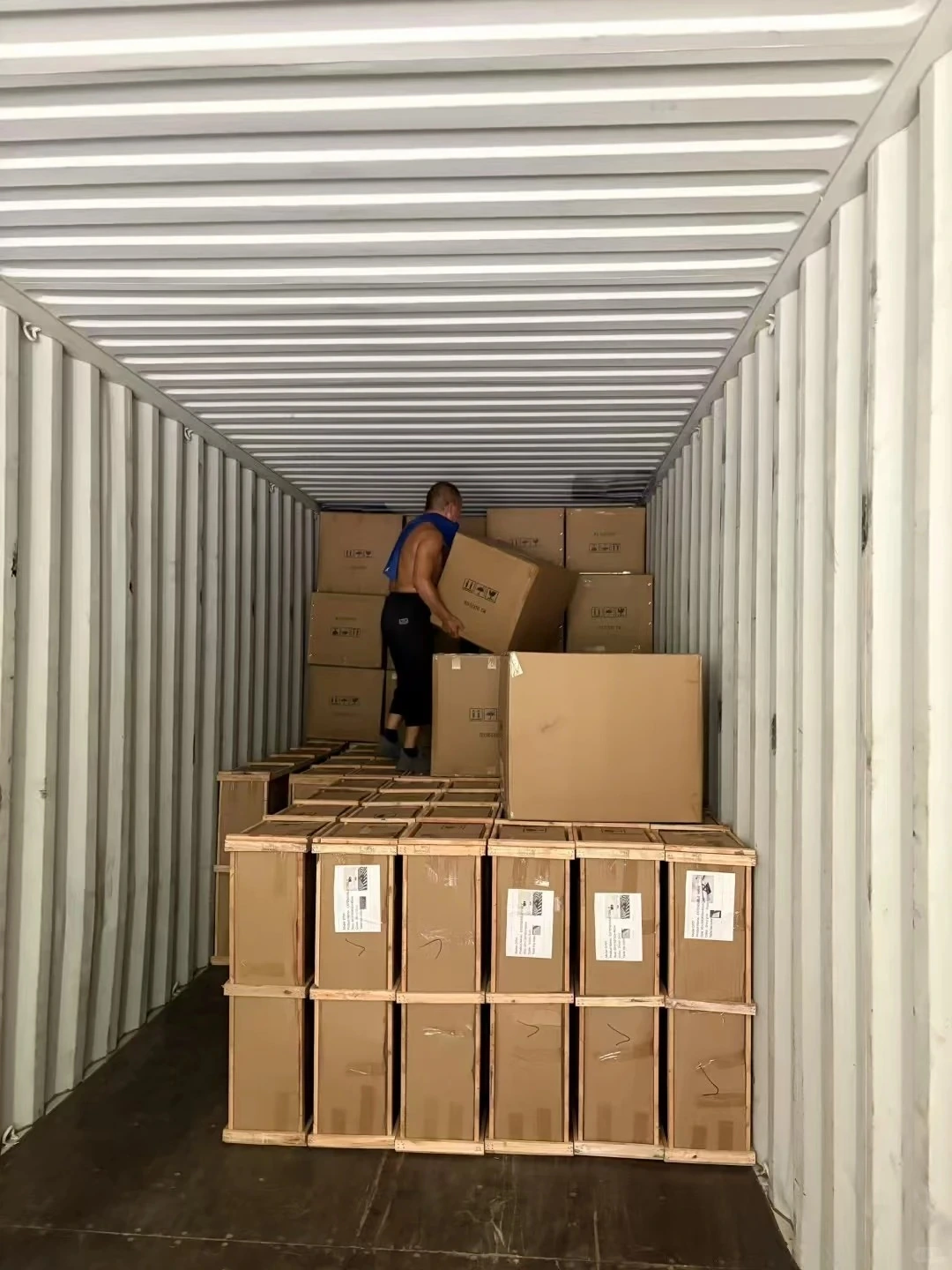

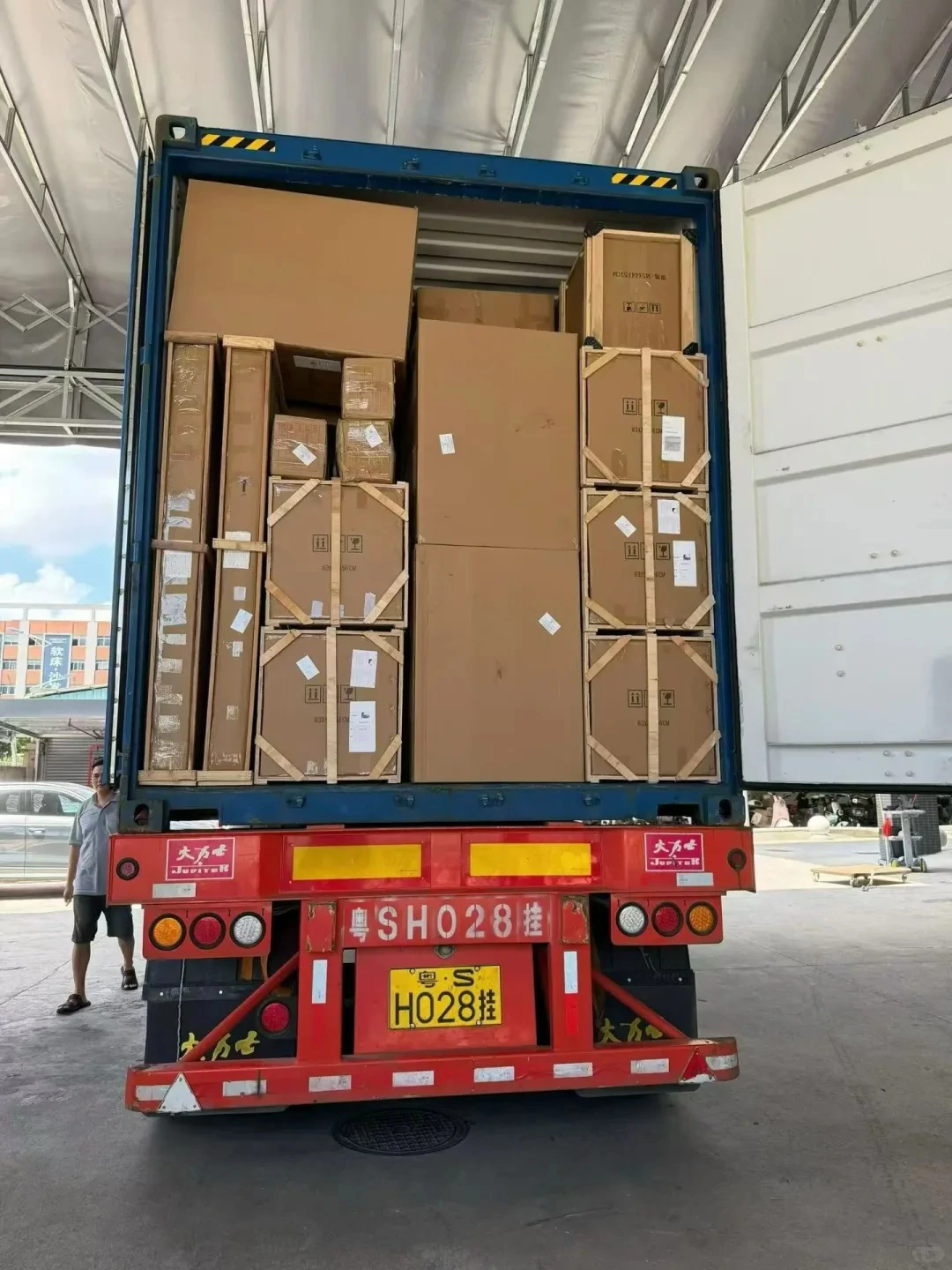

Passing product QC is only half the job. Cabinets must survive handling, consolidation and international transport. Verify corner protection, wrapping, cartons or crates, strapping, pallet support and labels. Parts should be grouped logically so installers can identify each module without opening every package.
For more context on the downstream process, see Ratahome’s Shipping & Delivery information and the broader How It Works workflow.

10. Document defects, corrections and final approval
A useful QC report identifies the cabinet or package, records what was checked, shows any defect with clear photos, and records the corrective action. After repair, the corrected item should be photographed again or re-inspected. This closes the loop between finding a problem and preventing it from being shipped.
| QC stage | What to record | Typical evidence |
|---|---|---|
| Specification | Cabinet ID, finish, dimensions, hardware | Drawing + measurement photo |
| Function | Door, drawer, accessory and lighting operation | Photos or short video |
| Appearance | Finish, edges, gaps, scratches, color consistency | Close-ups + full-module view |
| Correction | Defect, repair action and disposition | Before/after evidence |
| Packing | Package ID, protection and loading condition | Packing and container photos |

11. Pre-shipment cabinet inspection checklist for buyers
When sourcing custom cabinetry, ask the factory or project team to confirm these items before release:
| Checkpoint | What to verify |
|---|---|
| Drawings | Latest approved revision and cabinet IDs |
| Dimensions | Overall sizes, openings, fillers and critical interfaces |
| Panels | Material, thickness, drilling and edge treatment |
| Trial assembly | Reveals, module alignment, door and drawer clearances |
| Hardware | Correct model, secure fixing, smooth operation |
| Finish | Color, sheen, grain, scratches and visible defects |
| Accessories | Lighting, pull-outs and special mechanisms tested |
| Packing | Protection, labels, package list and loading evidence |
Related reading: Manufacturing & Quality, Quality Control, Materials & Finishes, and the Furniture Joinery Guide.
12. Quick FAQ
Is a final visual inspection enough?
No. Appearance is only one layer. Custom cabinetry also needs dimensional, functional, hardware and packing checks.
Should every cabinet be fully assembled?
The appropriate sampling and trial-assembly plan depends on project size and construction method. Critical modules and interfaces should receive enough assembly verification to expose fit problems before packing.
What evidence should a buyer request?
Ask for drawing references, measurement photos, trial-assembly photos, hardware/function evidence, finish close-ups, corrected-defect photos and packing/loading records.
